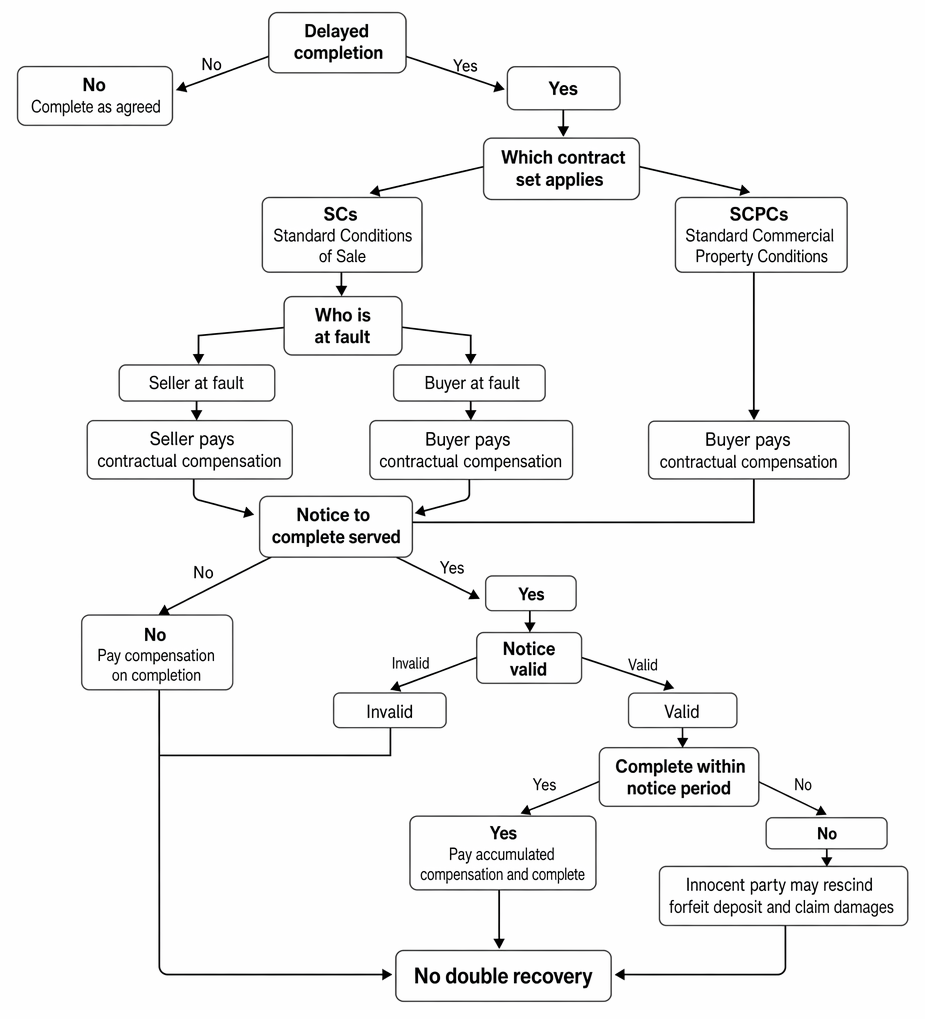

Overview
In property transactions, delayed completion can cause major legal and financial challenges. It's essential for legal professionals, especially those preparing for the SQE1 FLK2 exam, to be well-versed in the remedies available, particularly contractual compensation. This article explores the legal frameworks, compensation mechanisms, and strategic approaches to effectively manage delayed completion.
Legal Framework for Delayed Completion
Standard Conditions and Their Role
The Standard Conditions of Sale for residential properties and the Standard Commercial Property Conditions for commercial deals form the basis for handling delayed completion. These terms are standard in most property contracts, offering a consistent method to address delays and financial consequences.
Key provisions in standard conditions include:
- Completion Date: The set date to determine delays.
- Contract Rate: The interest rate for calculating compensation, typically 4% above a major bank's base rate.
- Calculation of Compensation: Based on the unpaid purchase price, excluding any deposit.
- Time Not of the Essence: Time is not initially stressed as critical in standard property contracts.
The Concept of "Time of the Essence"
Understanding this legal principle is important for understanding contractual compensation and the escalation of remedies in delay scenarios.
- Definition: When time is critical, the specified period for performance becomes a contract condition, breach of which may allow the innocent party to terminate the contract and claim damages.
- Default Position: Time is not initially critical for completion in standard property contracts.
- Making Time Critical: Achievable through express provision, serving a notice to complete, or occasionally through party conduct.
Compensation Mechanisms
Standard Contractual Compensation
The main tool for addressing delayed completion is the contractual compensation provision in standard conditions.
-
Trigger: Failure to meet the completion date.
-
Calculation Method:
Compensation = (Purchase Price - Deposit) × Contract Rate × (Days Delayed ÷ 365)
-
Duration: Compensation accrues daily from the day after the original completion date until completion.
-
Nature: Considered liquidated damages, reflecting a genuine pre-estimate of loss.
Notice to Complete
The notice to complete can transform the completion obligation's nature and enhance remedies.
- Purpose: To make time critical for completion.
- Requirements for Validity:
- Served after the original completion date
- Specifies a new completion date (typically 10 working days from service)
- Must be in writing and follow the contract's notice provisions
- Effects:
- Makes time critical for completion
- Continues the accrual of contractual compensation
- Allows the serving party to rescind the contract if completion is missed
Interaction with Common Law Remedies
It's vital to know how contractual compensation mechanisms relate to common law remedies for breach of contract:
- Damages for Breach: The innocent party may claim damages in addition to contractual compensation.
- Limitation: Damages awarded will be reduced by the contractual compensation received to prevent double recovery.
- Specific Performance: The court may order specific performance, compelling the defaulting party to complete the transaction.
Example: Calculating Contractual Compensation
Consider this scenario:
- Purchase price: £500,000
- Deposit paid: £50,000
- Contract rate: 5% (1% base + 4%)
- Delay: 7 days
Calculation:
Compensation = (£500,000 - £50,000) × 5% × (7 ÷ 365) = £431.51
This example shows how compensation accrues daily, underscoring the importance of prompt completion.
Case Study: Commercial Property Delay
A tech company agrees to purchase a commercial property for £2 million, with completion set for 1 September. Unexpected lender issues prevent timely completion.
-
Initial Phase:
- Compensation starts accruing from 2 September.
- Seller incurs costs preparing for completion.
-
Notice to Complete:
- On 8 September, the seller serves a notice to complete, setting 22 September as the new date.
- Time becomes critical.
-
Outcome:
- Buyer completes on 20 September.
- Total delay: 19 days
- Compensation: (£2,000,000 - £200,000) × 5% × (19 ÷ 365) = £4,684.93
- Additional damages: Seller claims £10,000 for costs due to delay.
-
Legal Analysis:
- Buyer owes £4,684.93 in compensation.
- Seller's claim for additional damages is valid but reduced by the compensation to avoid double recovery.
- Court might award the seller £5,315.07 in damages (£10,000 - £4,684.93).
This case shows the practical use of contractual compensation, notices to complete, and interaction with common law remedies.
Strategic Considerations for Practitioners
- Timing of Notice to Complete: Balance urgency with the risk of early termination.
- Documentation: Keep detailed records of communications, costs, and actions for claims.
- Alternative Dispute Resolution: Use mediation or other ADR methods to resolve disputes efficiently.
- Contractual Modifications: Alter standard conditions to address specific client needs or risks.
- Professional Risks: Advise clients on delays promptly to avoid negligence claims.
Conclusion
Proficiency in contractual compensation mechanisms and remedies for delayed completion is essential for SQE1 FLK2 success and legal practice. This area covers key aspects of property and contract law, requiring a solid grasp of both theoretical principles and practical skills. The ability to manage delayed completions, from compensation calculations to strategic use of notices, is vital for future property lawyers. A firm understanding will enable practitioners to effectively protect clients' interests in the evolving property market.
Key points:
- Standard conditions set the stage for dealing with delayed completions.
- The contract rate and calculation method determine compensation.
- Notices to complete can make time critical and lead to contract termination.
- Consider the interaction of contractual and common law remedies.
- Strategic delay management is crucial for protecting clients and reducing financial risk.
